MLNR · Survey Department

Bulk Land Survey

FormWorkflowOutputsE2E testDocs
PassedPassedPassedPassedPassed
End-to-end test
3/3 passed 2026-10-21 (mihud, combined)
Documentation
19 steps, 32 images · Download the DOCX
Who can apply
Individual, Organization
Catalogue ID
407

Fees

FeeCaseAmount (ZMW)
Land Survey Examination FeeNew1
Land Survey Initial FeeNew1
Land Survey Stat FilingNew111.2

Required documents

Output documents

Test evidence

Bulk Land Survey

Service documentation · Republic of Zambia · GSB e-Services

OwnerSurvey Department
Service keyMLNR/bulk-land-survey
Versionservice v1, platform a0a302b8
Date2026-10-21

Generated automatically by the service's end-to-end test run. Every screenshot shows synthetic test data on a local test installation, never real personal data.

This document describes the Bulk Land Survey service of Survey Department as the platform runs it today. It is generated by the service's end-to-end test: every step below was performed by the test, and every screenshot was taken during that run with synthetic data. Regenerate it with npm run docs:services in the e2e suite; do not edit it by hand.

1. Service summary

ItemDetail
ServiceBulk Land Survey
Owner (MDA)Survey Department (MLNR)
PurposeLand surveys are done to show the boundaries of a parcel of land. This survey service is for numbered unsurveyed land parcels. If you already have a survey diagram, go for the "Survey Diagrams Lodgement and Approval" service or "Supersede Diagram" for diagram replacement.
Who can applyIndividual; Organization
How to applyOnline on the national e-Services portal, signed in with ZamPass; pay with ZamPay.
FeesLand Survey Examination Fee: ZMW 1.00
Land Survey Initial Fee: ZMW 1.00
Land Survey Stat Filing: ZMW 111.20
Turnaround17 to 21 days depending on the type of Land Survey to be done
Validity of the output99 years
Required documentsNational Registration Card (NRC) (required)
Certificate of Incorporation / ZDA (if company, church, society) (required)
Numbered Site Plan (required)
Letter of Offer (optional)
Output documentsNotice of Action
Application form
GF-1 Treasury Invoice
GF-2 Treasury Receipt
Legal basisThe Land Survey Act No Chapter 188 of the Laws of Zambia (http://www.parliament.gov.zm/sites/default/files/documents/acts/Land%20Survey%20Act.pdf)
Chapter 188 - Land Survey Act: Subsidiary Legislation (Section 39) (https://zambialaws.com/subsidiary-legislation/chapter-188-land-survey-act-subsidiary-legislation)

2. Application process, step by step

The process as configured in the back office:

StepRoleTaskType
1ApplicantApplyform
2Case OfficerGenerate Paymentgenerate-payment
3ApplicantPaymentpayment
4SystemGenerate Documentgenerate-document
5Case OfficerReviewreview
6Case OfficerReviewreview
7Case OfficerReviewreview
8SupervisorVerify Paymentverify-payment
9ExecutiveDecisiondecision
10SystemGenerate Documentgenerate-document
11SystemNotify Clientnotify

Who takes part in this journey: Citizen, Case Officer, Supervisor, Executive, Anyone (public).

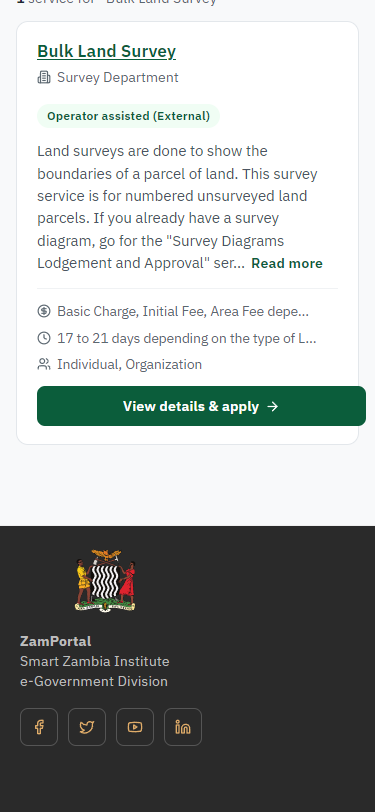

Step 1. Find the service

Citizen · National e-Services portal

On the national e-Services portal the citizen opens All Services and searches for the service by name ("Bulk Land Survey"). Each result names the service and the ministry that provides it.

Find the service (desktop) Find the service (375 px phone)

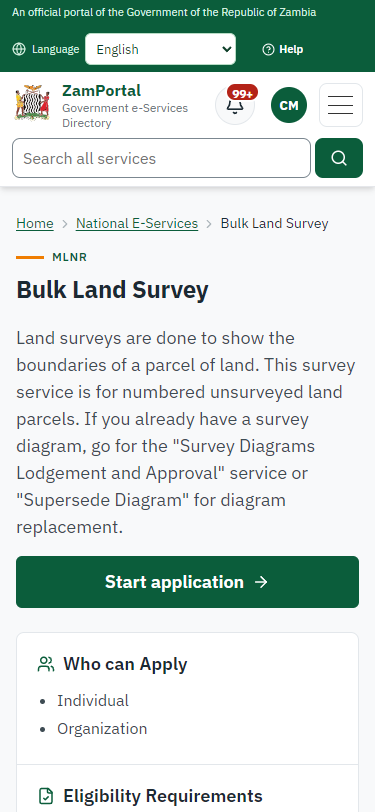

Step 2. Read the service page

Citizen · National e-Services portal

The service page sets out what the service is for, who provides it, the fee, how long it takes and the documents to have ready. "Start application" begins an application (the citizen is signed in with ZamPass).

Read the service page (desktop) Read the service page (375 px phone)

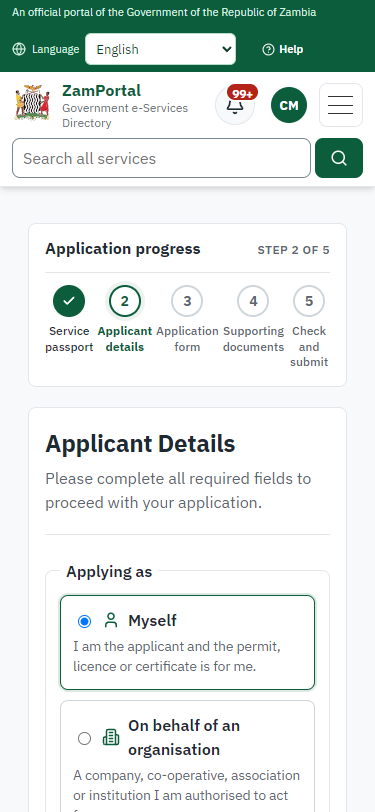

Step 3. Confirm the applicant details

Citizen · National e-Services portal

The applicant details are filled in from the citizen's ZamPass account. The citizen says whom they are applying for (themself) and continues with "Proceed to Application".

Confirm the applicant details (desktop) Confirm the applicant details (375 px phone)

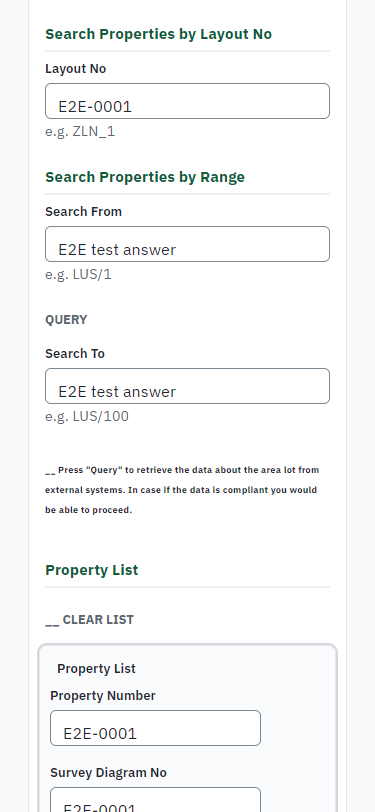

Step 4. Fill in the application form

Citizen · National e-Services portal

The citizen answers the service's own application form, converted from the legacy system (12 answers in this run, all synthetic), for the type of application "New". Questions marked * must be answered; some appear only after an earlier answer. Answers are saved as the citizen types, so an unfinished application can be reopened from My Workplace.

Fill in the application form (desktop) Fill in the application form (375 px phone)

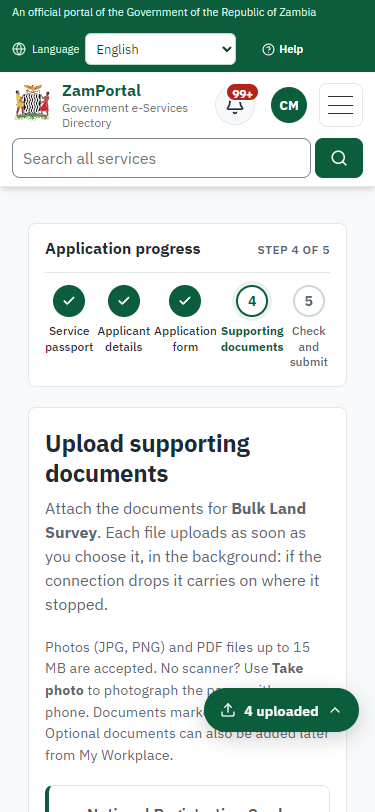

Step 5. Upload the supporting documents

Citizen · National e-Services portal

Each document the service asks for has its own upload (4 in this run: National Registration Card (NRC), Certificate of Incorporation / ZDA (if company, church, society), Numbered Site Plan, Letter of Offer). The files are checked and stored with the application; the page confirms each upload.

Upload the supporting documents (desktop) Upload the supporting documents (375 px phone)

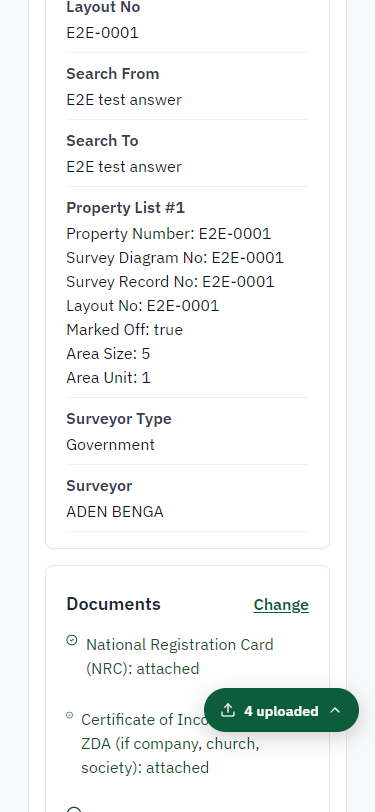

Step 6. Check the answers and confirm the declaration

Citizen · National e-Services portal

Before sending, the citizen sees every answer and document on one page and can go back to change them. The declaration that the information is true and complete must be ticked.

Check the answers and confirm the declaration (desktop) Check the answers and confirm the declaration (375 px phone)

Step 7. Application sent

Citizen · National e-Services portal

The portal confirms the application with the ministry's reference number (MLNR-BLS/00001/10-21-26 in this run). The application goes to the ministry's officers; the citizen follows it in My Workplace.

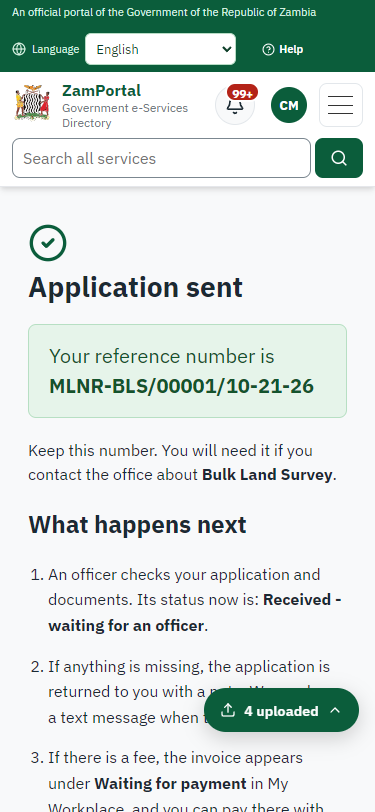

Application sent (desktop) Application sent (375 px phone)

Step 8. Take the new application on

Case Officer · Back office

The application arrives in the case queue of the ministry that owns the service (Survey Department); only its staff see it. The officer opens it by its reference number - answers, documents and process are on the case - assigns it to themself and takes it on.

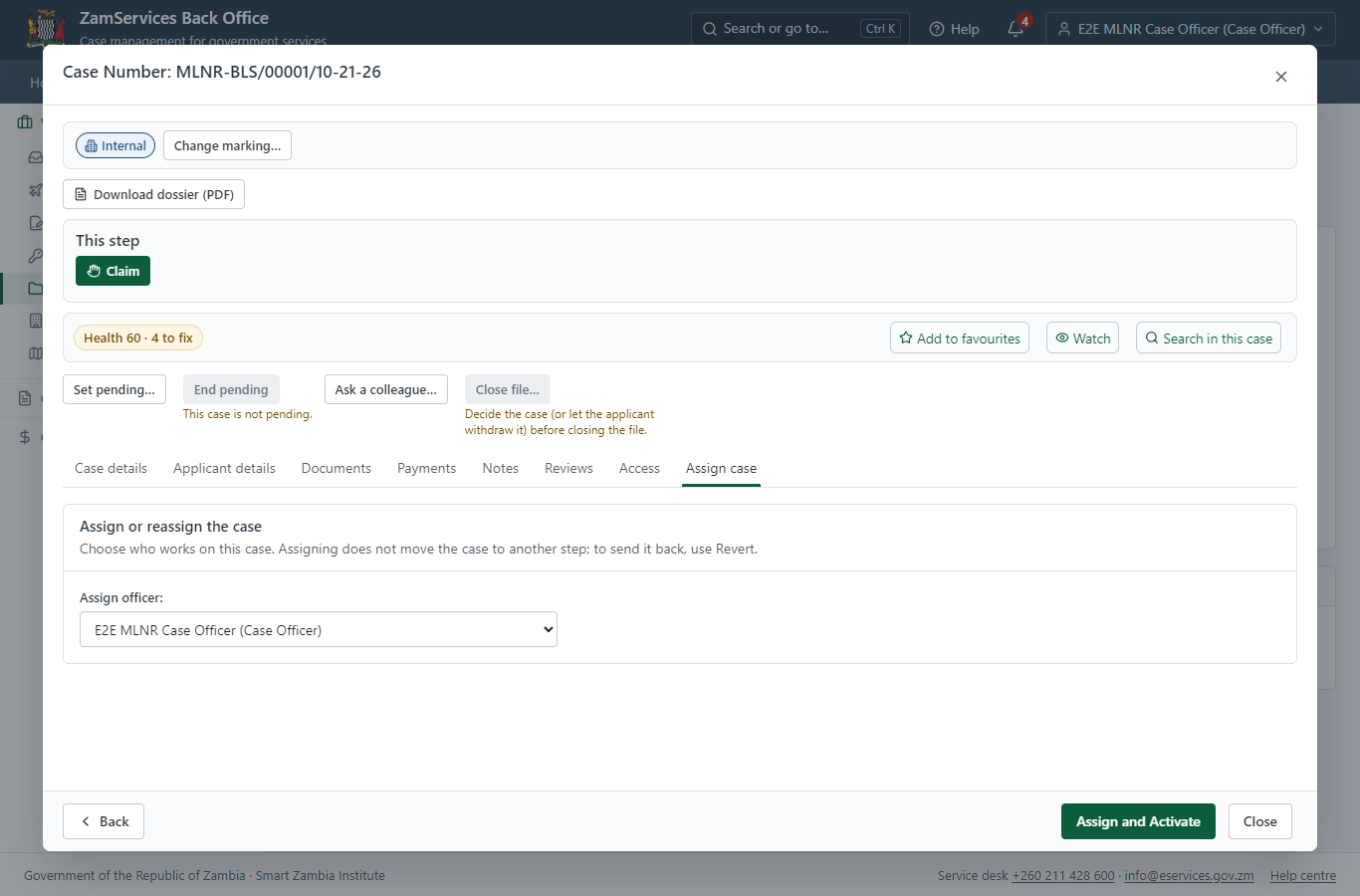

Take the new application on (desktop)

Step 9. Work out the fee

Case Officer · Back office

The Case Officer works out the fee from the service's imported fee schedule ("Basic Charge, Initial Fee, Area Fee dependent on the size of the piece of land"). "Submit Fees and Advance" records it, raises a ZamPay invoice for the applicant and moves the case to payment.

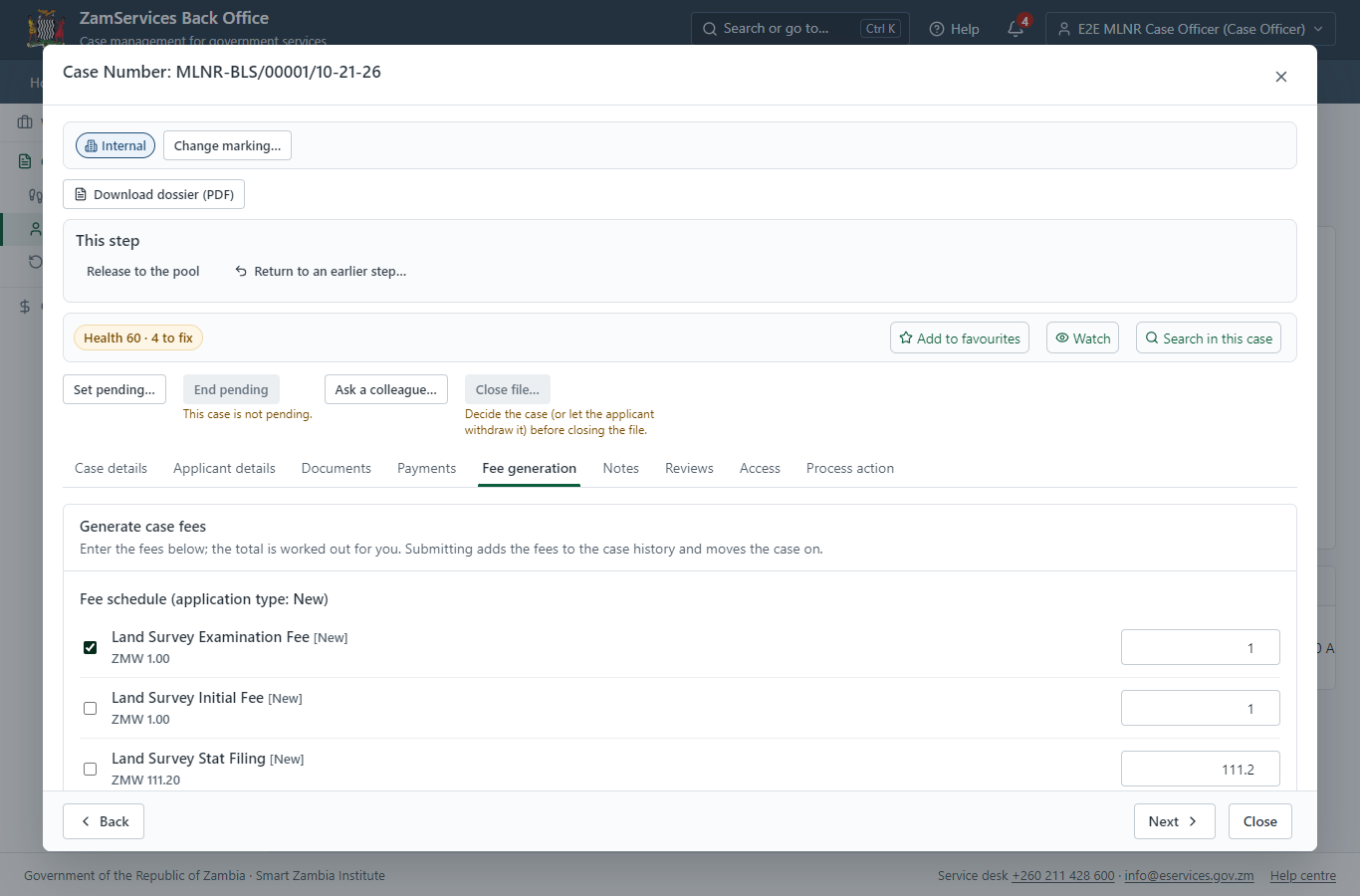

Work out the fee (desktop)

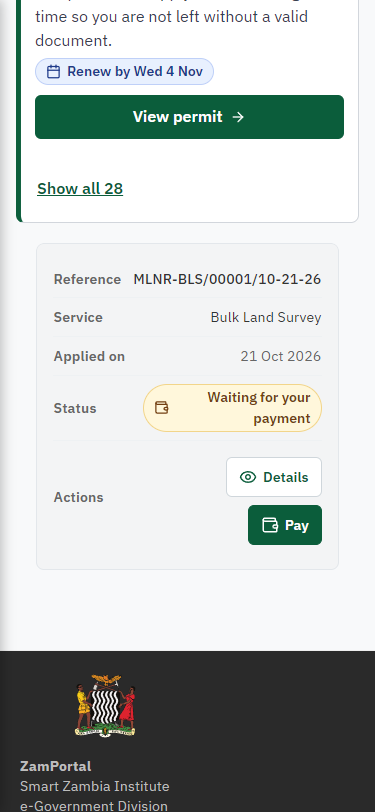

Step 10. See that the fee is due

Citizen · National e-Services portal

The application shows "Waiting for your payment" in My Workplace with a Pay button (K1.00). The office priced the case; the invoice was raised on ZamPay.

See that the fee is due (desktop) See that the fee is due (375 px phone)

Step 11. Pay with ZamPay

Citizen · National e-Services portal

Pay opens the invoice (K1.00, the amount set by the platform, never by the page) with its PDF preview; the citizen pays at ZamPay by mobile money or bank card.

Pay with ZamPay (desktop) Pay with ZamPay (375 px phone)

Step 12. Payment received

Citizen · National e-Services portal

ZamPay reports the payment; the dialog says "Paid. Thank you" and the application moves on to the ministry's officers.

Payment received (desktop) Payment received (375 px phone)

Step 13. Conduct survey, submit report (EXTRANET)

Case Officer · Back office

The Case Officer works on "Conduct survey, submit report (EXTRANET)" (review in the imported process), checks the application and its documents, and completes the step.

Conduct survey, submit report (EXTRANET) (desktop)

Step 14. Quality control of Survey Documents

Case Officer · Back office

The Case Officer works on "Quality control of Survey Documents" (review in the imported process), checks the application and its documents, and completes the step.

Quality control of Survey Documents (desktop)

Step 15. Download Survey Documents

Case Officer · Back office

The Case Officer works on "Download Survey Documents" (review in the imported process), checks the application and its documents, and completes the step.

Download Survey Documents (desktop)

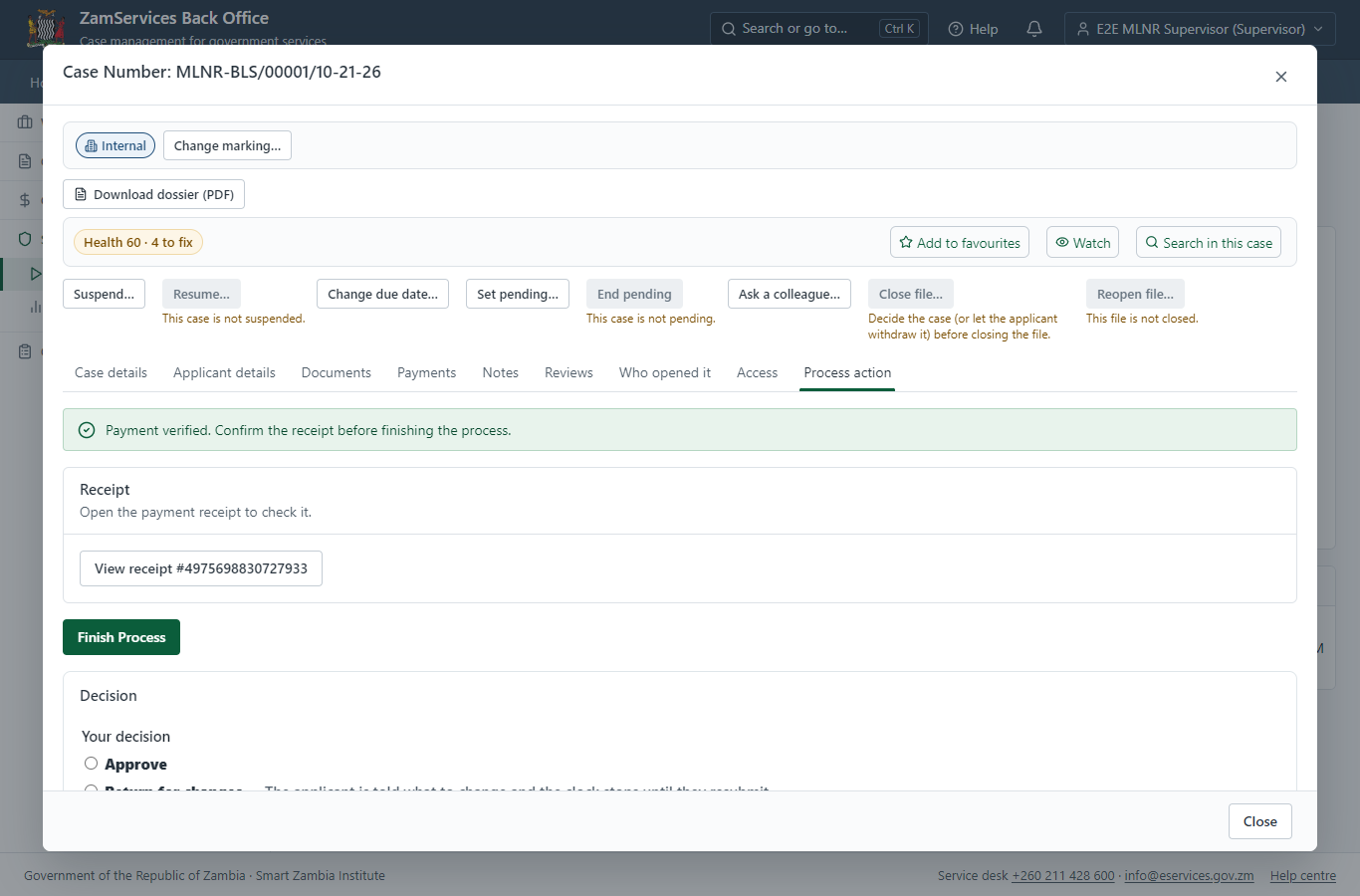

Step 16. Verify Payment Completion, Review Survey Report & Survey Diagram

Supervisor · Back office

The Supervisor works on "Verify Payment Completion, Review Survey Report & Survey Diagram" (verify-payment in the imported process), checks the application and its documents, and completes the step.

Verify Payment Completion, Review Survey Report & Survey Diagram (desktop)

Step 17. Decide: Review, Inspect, e-Sign Surveyor General

Executive · Back office

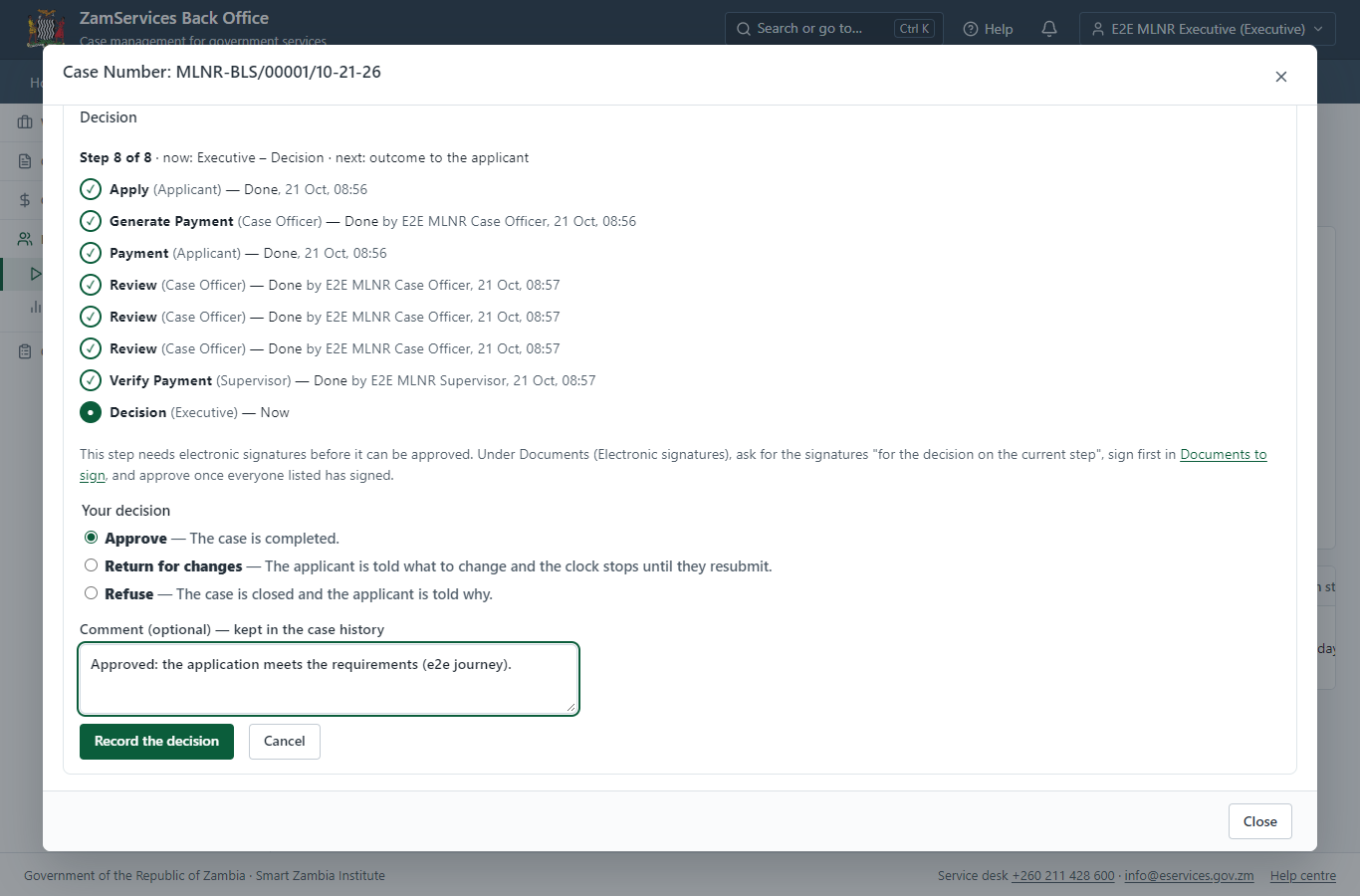

At "Review, Inspect, e-Sign Surveyor General" the Executive records the decision: approve, with a comment kept in the case history. Approving moves the case on; the last decision completes it and issues the document.

Decide: Review, Inspect, e-Sign Surveyor General (desktop)

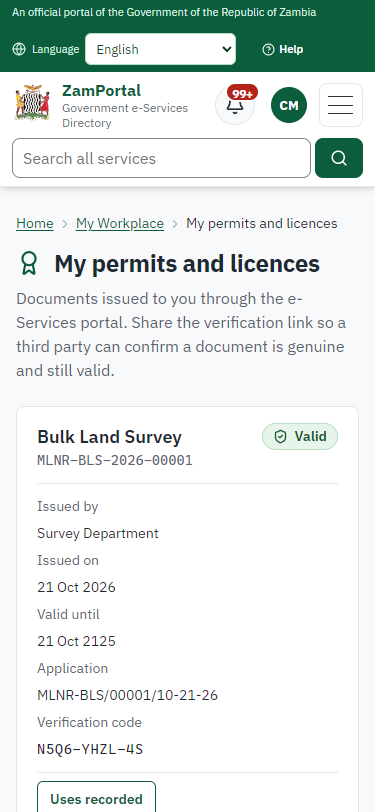

Step 18. The document in My permits

Citizen · National e-Services portal

The issued document (MLNR-BLS-2026-00001 in this run: "Bulk Land Survey") is listed in "My permits and licences" with its validity and a download of the sealed PDF.

The document in My permits (desktop) The document in My permits (375 px phone)

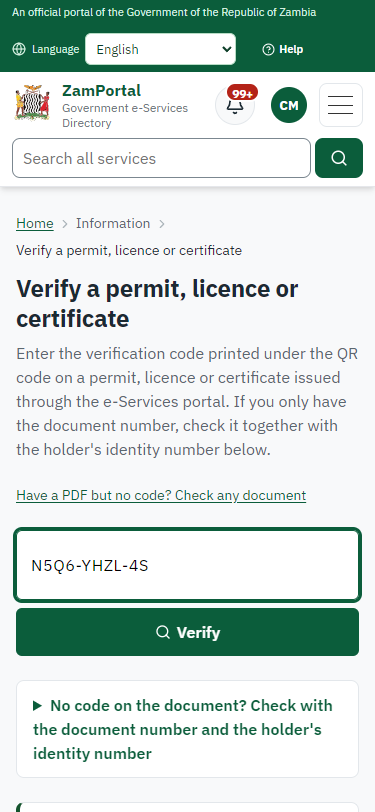

Step 19. Verify the document

Anyone (public) · Public verification page

The QR code on the document opens the public verification page: genuine and current, to whom it was issued, and whether the electronic seal is valid. No sign-in is needed.

Verify the document (desktop) Verify the document (375 px phone)

3. Payment

ItemIn the test run
Fee (as published)Basic Charge, Initial Fee, Area Fee dependent on the size of the piece of land
Invoice 14975698830727933
Amount 1ZMW 1.00
Paid at 1after "Work out the fee"

On screen: step 9 (Work out the fee), step 10 (See that the fee is due), step 11 (Pay with ZamPay), step 12 (Payment received) in section 2.

4. Output documents

Bulk Land Survey (sealed PDF)

Issued when the case was approved, from the service's output configuration (permitDocument/issued@1), filled from the application and the decision, sealed with the platform's electronic seal and stored as the issued version. The holder downloads it from My permits; the verification page checks it.

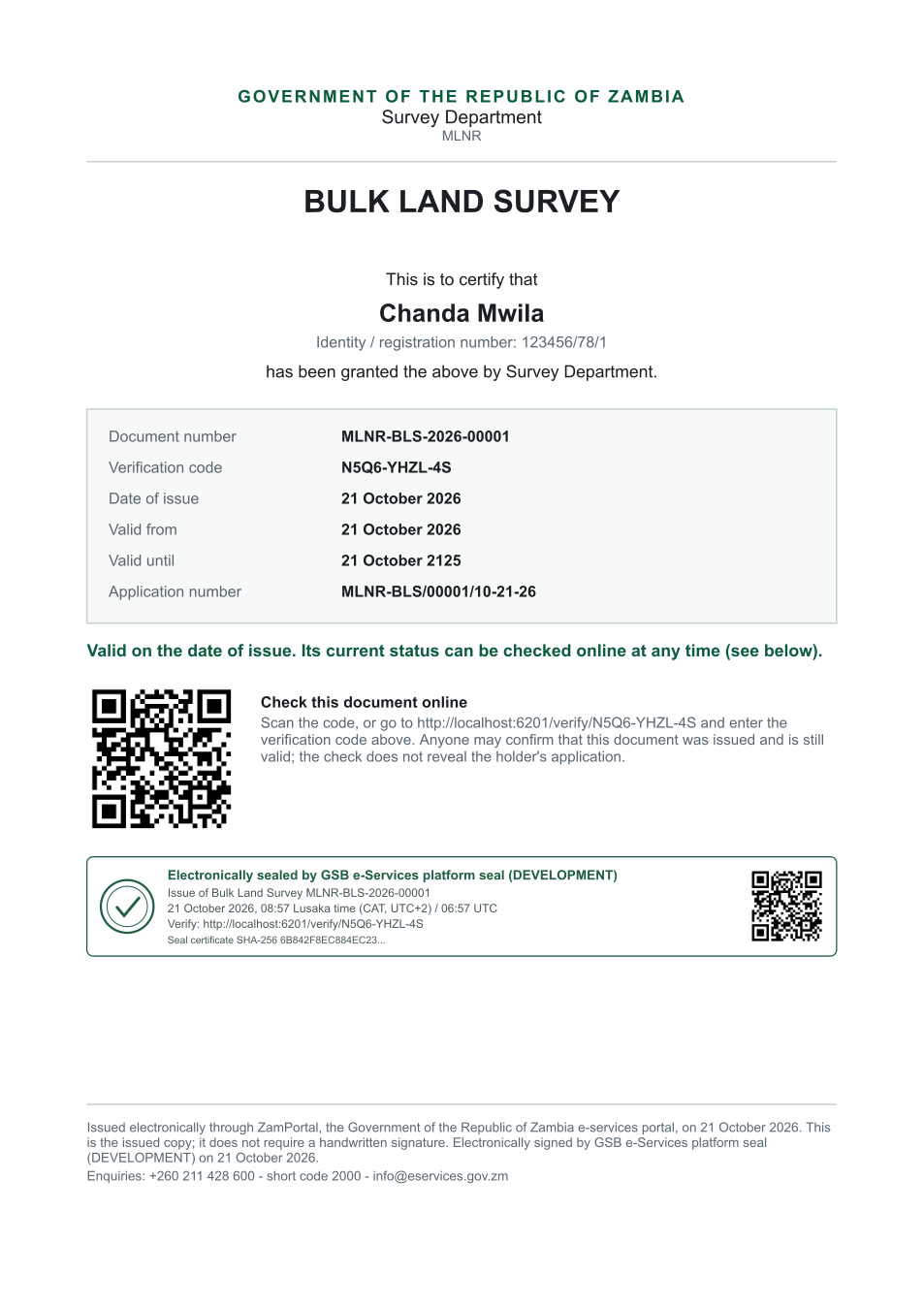

Bulk Land Survey (sealed PDF)

The issued PDF has 1 page; the image shows the first.

Fields

FieldValue in the test run
Document titleBulk Land Survey
Permit / licence numberMLNR-BLS-2026-00001
HolderChanda Mwila
Valid from2026-10-21
Valid until2125-10-21
Statusactive
Verification code (printed with a QR code)N5Q6-YHZL-4S

Seal

ItemDetail
Seal statussealed
Signature levelPAdES-B-T
Sealed bythe platform seal (development key in the test run)
Signed at2026-10-21T06:57:16.289Z
Trusted time-stamp2026-10-21T06:57:16.935Z (time-stamping authority)
Document fingerprint (SHA-256)a2360d80d939deef...

Verification

ItemDetail
WhereThe public verification page of the national portal, <portal>/verify/<verification code>, opened by scanning the QR code on the document.
What it showsWhether the document is genuine and current, its holder and validity, and whether the electronic seal is valid and who sealed it.
Checking a copyAnyone can upload a PDF they were given; the page says whether it is exactly the document that was issued. A changed copy is reported as not matching.

On screen: step 18 (The document in My permits), step 19 (Verify the document) in section 2.

5. Notifications

WhenChannelToMessageDelivery
Application receivedin-app (portal bell)the applicantApplication MLNR-BLS/00001/10-21-26 received - Your application MLNR-BLS/00001/10-21-26 for Bulk Land Survey has been received by Survey Department.shown
Status changedin-app (portal bell)the applicantUpdate on application MLNR-BLS/00001/10-21-26 - MLNR-BLS/00001/10-21-26 (Bulk Land Survey) is now: With the office - fees being worked out.shown
Payment due (invoice raised)in-app (portal bell)the applicantPayment due for application MLNR-BLS/00001/10-21-26 - The fee of ZMW 1.00 for Bulk Land Survey (MLNR-BLS/00001/10-21-26) is now due. Invoice 4975698830727933.shown
Payment receivedin-app (portal bell)the applicantPayment received for MLNR-BLS/00001/10-21-26 - Your payment of ZMW 1.00 for MLNR-BLS/00001/10-21-26 (Bulk Land Survey) has been received. Receipt: <ZamPay>/pdf?documentType=receipt&invoiceNumber=4975698830727933shown
Decision: approvedin-app (portal bell)the applicantApplication MLNR-BLS/00001/10-21-26 completed - MLNR-BLS/00001/10-21-26 (Bulk Land Survey) is complete. Your documents are ready.shown
Licence / permit issuedin-app (portal bell)the applicantYour Bulk Land Survey document has been issued - MLNR-BLS-2026-00001 has been issued for Bulk Land Survey and is valid until 21/10/2125.shown
Invitation to rate the servicein-app (portal bell)the applicantHow was Bulk Land Survey? - How was Bulk Land Survey? Tell us in about a minute.shown
Application receivedsms+260 97* *** 567Application MLNR-BLS/00001/10-21-26 for Bulk Land Survey has been received. Track it: <portal>/my-workplacedelivered
Application receivedemaile2e.c***@example.testApplication MLNR-BLS/00001/10-21-26 receivedskipped
Status changedsms+260 97* *** 567delivered
Payment due (invoice raised)emaile2e.c***@example.testPayment due for application MLNR-BLS/00001/10-21-26skipped
Payment due (invoice raised)sms+260 97* *** 567Fee of ZMW 1.00 due for MLNR-BLS/00001/10-21-26. Invoice 4975698830727933. Pay: <ZamPay>/pay-for-service/get-invoice/4975698830727933delivered
Payment receivedsms+260 97* *** 567delivered
Invitation to rate the servicesms+260 97* *** 567skipped
Invitation to rate the serviceemaile2e.c***@example.testHow was Bulk Land Survey?skipped
Decision: approvedemaile2e.c***@example.testApplication MLNR-BLS/00001/10-21-26 completedskipped
Licence / permit issuedsms+260 97* *** 567delivered
Licence / permit issuedemaile2e.c***@example.testYour Bulk Land Survey document has been issuedskipped
Decision: approvedsms+260 97* *** 567delivered

Delivery: shown = in the portal's notification bell; delivered = the SMS gateway (a test double in this run) reported the text delivered; skipped = not sent on that channel (e-mail is not configured on the test installation, and some notices go out on one channel only); sent by the national portal = a ministry node handed the notice to the national portal, which texts and e-mails the citizen under its own name and the citizen's preferences. Addresses written <portal>, <ZamPay> stand for the national portal and ZamPay.

6. Legacy mapping

ItemDetail
ReplacesBulk Land Survey in the legacy ZIGS e-Services directory (ZIGS_Services)
Legacy service id407
Legacy providerSurvey Department (MLNR) under Ministry of Lands and Natural Resources
Legacy processStandard.Review_3Step (process 103)
Fee in the legacy systemLand Survey Examination Fee: ZMW 1 (New)
Land Survey Initial Fee: ZMW 1 (New)
Land Survey Stat Filing: ZMW 111.2 (New)
Fee taken before submissionyes (as in ZIGS)
Time to issue (legacy)New: 21 working days
Legacy output templatesNotice of Action: ZIGS_Forms_Notices / GS-2.NoticeOfAction
Application form: ZIGS_Forms_MLNR / MLNR_BulkLandSurvey.Application
GF-1 Treasury Invoice: ZIGS_CustomForms / GF-1 Invoice
GF-2 Treasury Receipt: ZIGS_CustomForms / GF-2 Receipt
Legacy addressnone recorded
How it was brought overImported by the platform's legacy catalogue importer (zcm-backend scripts/zigs/importLegacy.js) from the ZIGS snapshot: form, case types, fees, documents, process and output templates, then served by the new platform.

7. Version and date

ItemDetail
Document versionservice v1, platform a0a302b8
Generated2026-10-21T06:57:24Z (by the end-to-end run, not edited by hand)
Service versionnot versioned (configured directly)
Platform snapshotbackend a0a302b8
portal 72805f0
back office 58e5946
Test suitee2e 5999d9b; one installation (combined); seed profile mihud
Journeys30-catalogue-service.spec.js: citizen finds the service, answers its form, uploads its documents and sends the application - passed
30-catalogue-service.spec.js: the case goes through every step of its process: payments by the citizen, each officer step by its role - passed
30-catalogue-service.spec.js: the grant document is issued, sealed, filled in and verifiable; the citizen has it in My permits - passed
Result3 of 3 journey tests passed
DataSynthetic test data on a local test installation; provider test doubles for ZamPass, ZamPay, SMS and signing.
